Sorry Mr. AI, But We’re Out of Power: The Looming Energy Crisis for Generative AI-at-Scale

Image: Depositphotos enhanced by Cogworld

Source: Dr. Claudio Lima

Will GenAI scale without enough power to accelerate multi-trillion parameter LLM training, causing economic fallout and impacting GDP growth?

The rapid expansion of Generative AI (GenAI) and Large Language Models (LLMs), like GPT, Gemini and LLaMA, has drastically increased the need for computational power, especially as models scale from billions to trillions of parameters. Training these multi-trillion parameter models demands specialized hardware, notably NVIDIA’s H100 and upcoming GB200GPUs, which are designed to handle the immense Teraflop computation processing requirements of such massive model parameters count and datasets. These GPUs outperform traditional models in both speed and efficiency, but at the cost of significantly higher power consumption.

However, the power needed to fuel these massive AI systems is growing at an alarming rate. As AI’s hunger for computational resources grows, the power supply required to support them is becoming a bottleneck.

What happens when there isn’t enough energy to sustain the expansion of AI-at-scale?

Electricity demand in the United States is expected to rise significantly due to the rapid expansion of data centers, especially those supporting AI infrastructure. Between 2024 and 2030, demand is projected to increase by about 400 terawatt-hours, driven by a compound annual growth rate (CAGR) of approximately 23% [1].

New AI data centers alone could account for 30–40% of all new net electricity demand added during this period.

This growth is compounded by rising energy needs from other sectors such as domestic manufacturing, electric vehicles, and green hydrogen production electrolyzers, amidst a backdrop of overall stagnant power demand since 2007, as shown in Figure 1.a.

US Data Centers to Drive 400 Terawatt-Hour Electricity Surge by 2030



Image: Claudio Lima, PhD.  Fig. 1.a — Demand for power for data center in the US by 2030 (source: McKinsey, Oct 2023)



The Emergence of Hyperscale AI Data Centers and the Growing Power Requirements for AI GPUs

In comparison to earlier GPU models like NVIDIA’s A100, the H100 provides a significant leap in performance due to its advanced Tensor Cores, which are specifically designed to handle the massive workloads demanded by generative AI (GenAI) inference tasks and training, running multi-trillion parameter models. However, this performance boost comes with a marked increase in energy consumption. Traditional GPUs, like the A100, which have a Thermal Design Power (TDP) of around 400W, typically drew about 10– 15kW per rack in AI-focused data centers.

In contrast, high-density racks outfitted with H100 GPUs can demand as much as 30–40kW per rack, driven by the H100’s higher TDP of 700W per GPU. This represents a substantial increase in power requirements, reflecting the growing complexity and scale of AI models, which are rapidly expanding from hundreds of billions to trillions of parameters.

Furthermore, the recently announced GB200 ‘Blackwell’ GPU, with a TDP of 1000W, signifies another jump in power consumption, making MegaWatt (MW)-scale energy requirements and efficiency a critical consideration for new GenAI infrastructure. These advancements are pushing even the most advanced data centers to their operational limits, necessitating new approaches to power management and energy provisioning for the future of GenAI-at-scale, as shown in Figure 1.b.



Image: Claudio Lima, PhD. Fig. 1.b — Evolution of GPU power requirements and its impact on AI hyperscale AI data centers



Managing High-Density Power Requirements in Modern AI Data Centers

This shift to high-density racks represents a fundamental transformation in new AI data center design, moving away from traditional enterprise computing workloads that prioritized enterprise, social media and other business processing with moderate energy demands. Modern GenAI data centers, in contrast, require extreme computational performance, driving unprecedented energy demands and thermal management challenges.

As GenAI LLM models continue to scale in complexity and size, hyperscale AI data centers must fundamentally reimagine their power delivery systems and cooling architectures.

Managing these soaring power requirements presents multiple challenges: i) existing power grid infrastructure limitations, and the need for more sophisticated power distribution systems within facilities, ii) enhanced cooling solutions to handle the increased heat density, and iii) growing pressure to meet sustainability goals. Today’s hyperscale AI data centers must therefore balance three critical factors: 1) maximizing computational performance, 2) ensuring reliable power delivery and cooling, and 3) maintaining energy efficiency — all while supporting the exponential growth requirements of GenAI LLM training and inference and AI-at-scale operations.

The Foundation of the AI Digital Infrastructure Design Framework

Scaling AI to support multi-trillion parameter LLM (Large Language Model) training requires more than just incremental improvements; it demands a revolutionary approach to infrastructure design. A new framework for hyperscale AIdata center design is required — the “AI Compute Fabric” — provides a robust foundation to support the immense computational, storage, and high speed, high capacity and low latency networking requirements of AI-at-scale.

The AI Compute Fabric consists of several key building blocks that, when combined, form a highly efficient, scalable architecture designed to handle the extreme processing demands of AI. Each component has been designed to optimize energy efficiency, data transfer, and compute power, forming the bedrock for future AI applications.



Image: Claudio Lima, PhD. Fig. 2 — Building blocks of an hyperscale AI data center with modular Nx 1MW AI clusters



Key AI Compute Fabric Building Blocks

The next generation AI compute fabric is comprised of:

1. xPU Processing Units (AI Compute Layer): The core of the AI Compute Fabric consists of xPUs, which include GPUs (Graphics Processing Units), TPUs (Tensor Processing Units), CPUs (Central Processing Units), and specialized AI accelerators (e.g., Language Processing Unit (LPU)). GPUs and TPUs handle the intensive training of large AI models, while specialized accelerators focus on LLM inference optimization. These units work in concert to efficiently manageboth training and deployment (inference) phases of AI workloads.

2. High-Bandwidth Memory (HBM) and Distributed Storage (AI Data Layer): To handle the massive model parameters required for AI model training and inference, high-bandwidth memory (HBM) and hierarchical distributed storage architectures are employed. HBM enables faster data access and reduced latency, crucial for multi-trillion parameter LLM models. The Storage Layer implements a tiered approach, combining high-speed cache, NVMe storage, anddistributed file systems to ensure optimal data availability and throughput.

3. Networking Interconnections (AI Connectivity Layer): The AI Connectivity Layer utilizes high-bandwidth, low-latency networking with advanced protocols and topologies optimized for AI workloads. This includes InfiniBand or similar Ethernet technologies capable of supporting 400–800 gigabits per second of bandwidth with microsecond-level latencies. The network architecture must support both east-west traffic between compute nodes and north-south traffic forexternal data access. This layer facilitates real-time collaboration between compute units, employing advanced parallelism techniques such as distributed training and model parallelism, which are essential in large-scale model training and inference. The network fabric must also support advanced features like RDMA (Remote Direct Memory Access) and GPUDirect to minimize data movement overhead and optimize inter-GPU communication in AI clusters.

4. Thermal Management and Cooling (AI Cooling Layer): The AI Cooling Layer implements advanced thermal management solutions to handle unprecedented power densities. While traditional air cooling remains relevant for some components, direct liquid cooling (DLC) or immersion cooling becomes essential for high-density GPU clusters exceeding >50kW per rack. Modern cooling designs must maintain optimal operating temperatures (typically between 20–35°C for GPUs) while supporting the extreme power densities of next-generation AI GPUs. Cold plate liquid cooling solutions or two-phase immersion cooling can achieve heat transfer coefficients 1000x higher than traditional air cooling, making them crucial for removing heat from high-density AI clusters. The use of these efficient cooling technologies ensures that the data center operates within safe temperature ranges while minimizing energy loss — that may affect GPUs and cause delays in the LLM training process — with cooling power requirements typically representing in some cases 20–30% of total facility power consumption.

5. Power Distribution Units (AI Energy Management Layer): The AI Energy Management Layer encompasses both power delivery and efficiency management critical for AI infrastructure. Modern Power Distribution Units (PDUs) must support high-density power delivery (up to 400V DC) while maintaining reliability and efficiency at unprecedented loads. While a Power Usage Effectiveness (PUE) of 1.1–1.15 represents an ideal target, achieving this requires sophisticated power management systems. This includes real-time monitoring and analytics of power consumption patterns, advanced busway distribution systems rated for 400–1000A, and redundant Uninterruptible Power Supply (UPS) systems operating in high-efficiency modes. The implementation of smart PDUs with branch circuit monitoring enables granular power control, while dynamic AI load balancing and workload scheduling optimize energy usage. Power capping and throttling capabilities further ensure optimal AI workload performance within power constraints. This comprehensive power management framework minimizes power wastage through intelligent distribution and monitoring, ensuring that maximum energy is directed toward processing workloads rather than auxiliary systems. For AI hyperscale facilities, achieving optimal PUE requires careful integration of all power components, from utility-scale power delivery to rack-level power management, while maintaining N+1 or 2N redundancy for critical systems.

Scalability and Efficiency

As defined above, each AI Compute Unit is designed with a base power consumption of 1MW, forming the foundational building block of the hyperscale data center. This unit represents a standardized cluster of high-density GPU racks (>50kW per rack), which can be combined modularly into larger compute blocks (e.g., 4MW blocks using 4 units) for seamless scaling up to 100MW or more in large hyperscale deployments. By building on these standardized 1MW compute units, the AI Compute Fabric enables flexible and incremental scaling of AI infrastructure while maintaining operational efficiency at any scale.

The Role of High-Performance GPUs in AI Infrastructure

As seen in Figure 1,b at the heart of this AI infrastructure are high- performance GPUs such as NVIDIA’s H100 (700W TDP) and GB200 GPUs (1000W TDP).

These GPUs are purpose-built for the high computational throughput required by AI workloads, leveraging massive parallel processing to train and run inference on multi-trillion parameter LLM models.

The AI Compute Fabric establishes a comprehensive framework for hyperscale AI data centers based on standardized 1MW compute units. By integrating advanced GPU clusters, high-bandwidth memory, optimized networking fabric, efficient liquid cooling systems, and intelligent power management, this modular architecture provides the scalable, energy-efficient foundation needed for the design and operation of next-generation AI infrastructure. As AI models continue to grow in size and complexity, this architecture will serve as the backbone of global AI deployments, enabling breakthroughs across industries from healthcare to autonomous systems and beyond.

Meeting the Insatiable Energy Demands to Power Hyperscale GenAI Data Centers

Hyperscale AI data centers are facing unprecedented power demands due to the computational requirements of training multi-trillion parameter LLMs like GPT-4 and LLaMA3 models. Unlike traditional data centers operating at 10–20MW with lower rack densities (5–10kW), these centers now require 100MW-1GW of consistent power. Built from standardized 1MW compute units, high-density GPU clusters (>50kW per rack) are pushing the limits of existing utility infrastructure, demanding modular approaches for efficient power infrastructure planning and deployment to support this growing scale effectively.

Currently, utilities are struggling to cope with the immense power demands of AI LLM training, challenging both power delivery capabilities and grid capacity upgrades

To meet the unprecedented power demands of hyperscale AI data centers, stable and firm power sources are crucial. Nuclear power plants, including future small modular reactors (SMRs), hydroelectric power plants, and combined heat andpower (CHP) natural gas power plants with turbine generators are the most likely energy source, which may provide 70–90%, or even 100%, of the needed energy. These baseload sources deliver the consistent, reliable power that AI training requires, as shown in Figure 3.



Image: Claudio Lima, PhD. Fig. 3 — Power sources mix for hyperscale AI data centers for AI training and inference-at-scale



Behind-the-meter (BTM) onsite generation solutions, such as MW-scale CHP natural gas power plants, provide critical power independence, enabling island mode operation, combined with advanced microgrid controllers, for uninterrupted facility operation.

This capability is crucial as utilities often face multi-year delays in delivering the full capacity required for hyperscale AI centers due to necessary grid upgrades and interconnections. When available, MW-scale grid interconnection agreements (Power Purchase Agreements — PPA) can be added to the remaining mix to balance (10–20%) the onsite power generation-load dynamics, including adding the offer of grid flexibility services.

This is especially critical as utilities often cannot deliver the full capacity required for hyperscale AI data centers without long delays for grid upgrades.

While renewables like solar and wind are increasingly integrated into data center power strategies, their intermittent nature limits their role as primary power sources for AI data center. They may contribute only 10– 20% of the total energy mix, even when paired with large-capacity energy storage systems, due to the need for consistent, firm power for AI workloads.

How Utilities Are Falling Behind in Powering AI LLM Training Amid Grid Expansion Delays

The scale of utility infrastructure upgrades needed for hyperscale AI data centers is unprecedented. By 2027, global data center power consumption is expected to surpass 1 million gigawatt-hours (GWh) annually, growing at a compound annualrate of 10% to 24% [1–6].

Understanding the Scale: 1GW AI Facility’s Power Equivalency

For context, a 1GW hyperscale AI multi-campus facility demands the equivalent power capacity of approximately two large natural gas combined cycle plants (500–600MW each) or one unit of a nuclear power plant (1– 1.2GW per unit). This massive power consumption could supply energy to approximately 800,000 US households, equivalent to powering a major metropolitan area like Dallas or Houston (EIA). This comparison shows the unprecedented scale of energy infrastructure needed to support modern AI operations.

Grid Delays Drive Alternative Generation for AI Data Centers

In the U.S., data center electricity demand is expected to exceed supply by 2028 [1–6], necessitating a 7% to 26% increase in annual energy generation — significantly higher than the largest historical five-year increase of 5%.

Meeting new AI data center demand will require more than $2 trillion in global utility investments in new energy generation resources, which will likely drive a 10% increase in U.S. utility annual revenue and may result in an approximate 1% annual increase in customer bills over the next decade [2–3].

This challenge is further complicated by infrastructure delays, as building new substations and transmission lines can take 6–10 years, creating a critical gap between energy needs and supply. In response, hyperscale AI centers are turning to onsite behind-the-meter (BTM) natural gas generation, which could demand billions of cubic feet per day (Bcf/d) of gas. Therefore, BTM power generation solutions and co-located facilities are emerging as key alternatives, enabling datacenters to bypass grid delays while securing reliable energy to drive new AI data center load requirements.

Utilities are facing growing difficulties in matching the skyrocketing energy demands of new AI model training requirements with timely infrastructure expansions, further impeding thedeployment of these power-intensive AI data centers. The need for alternative energy sources is becoming increasingly urgent to avoid bottlenecks in AI scalability.

The Gold Rush for AI Data Center Power: Supply Constraints and Lead Time Delays in the Face of AI’s Computational and Power Demands

Hyperscale AI data centers are facing a “gold rush” for essential resources like electrical generators, power systems, and high-performance computing units. Supply chain constraints, including production delays and inventory shortages, are significantly slowing down construction of these facilities, with lead times for essential components stretching from 18 to 36 months or even longer. These bottlenecks threaten to stifle the anticipated growth of AI-driven industries, directly impacting the potential economic boom that AI is forecasted to generate.

The AI economy, projected to contribute trillions of dollars across sectors such as healthcare, finance, manufacturing, and more, is heavily dependent on the timely deployment of these hyperscale AI data centers.

Persistent supply chain issues could delay the transformative potential of AI, slowing productivity improvements and innovation across industries. Additionally, this could hinder advancements in critical areas like healthcare diagnostics, smart manufacturing, and financial analytics, all of which rely on rapid AI deployment.

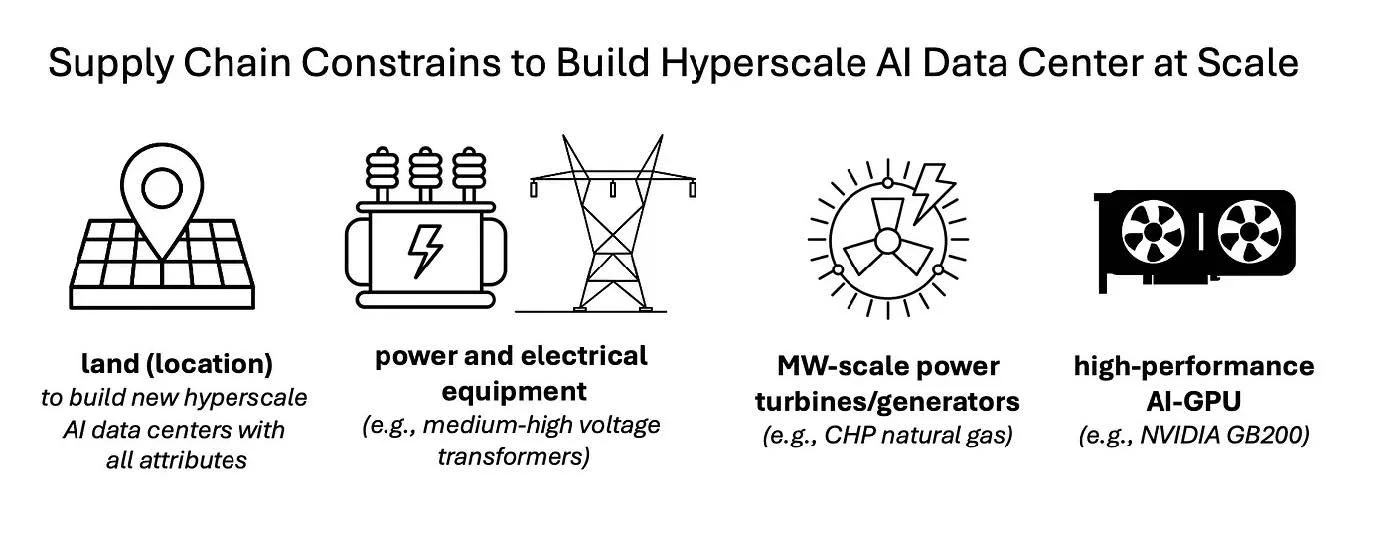

Figure 4 illustrates the key resources delaying AI-at-scale deployment due to critical supply chain and time-to-market challenges.



Image:: Claudio Lima, PhD. Fig. 4 — Key supply chain constraints for building AI hyperscale data centers



Critical Supply Chain Bottlenecks in Hyperscale AI Infrastructure Deployment

As hyperscale AI data centers expand, they face critical supply chain constraints that severely hinder their ability to scale and meet growing demands for computational power and resources, including energy, hardware, and infrastructure. These constraints include:

1. Land (Location with all attributes)

Securing appropriate land for hyperscale AI data centers presents an immediate challenge. These data centers require large plots of land situated near power grids, cooling resources, water resources, and robust fiber optic network infrastructure (attributes). The competition for these strategic locations has increased, leading to a surge in land prices and slowing down the acquisition process. Without securing prime locations, project timelines for the construction of AI data centers can be pushed back significantly, delaying the ability to meet growing demand and hindering the expansion of necessary digital infrastructure.

2. Electrical Equipment Constraints for Hyperscale AI Data Centers

Hyperscale data centers, which require up to 100MW-1GW of continuous power, depend heavily on essential electrical components such as medium-voltage transformers, UPS, medium-voltage switchgear, and power distribution units (PDUs) to ensure efficient energy management and distribution. These components play a critical role in delivering uninterrupted power, even during AI workload training transients. However, due to surging demand, manufacturers of thesekey infrastructure elements are facing significant supply chain bottlenecks, leading to production delays. The lead times for medium-high voltage transformers and other critical electrical equipment are now often 24–36 months or longer.

This shortage of critical electrical equipment represents one of the largest obstacles to bringing new AI data centers online. Without key components like medium-voltage transformers and UPS systems, even completed data centers remaininoperable. These production and deployment delays not only slow the growth of AI infrastructure but also exacerbate the energy challenges faced by the industry, as it scales to support increasingly power- hungry workloads. Addressing these supply chain constraints is essential for realizing the full potential of hyperscale AI data centers and ensuring that they can meet the growing power demands of next-generation AI model creation.

3. Power Turbine and Generator Constraints for Hyperscale AI Data Centers

Hyperscale AI data centers rely on MW-scale power turbines and generators to meet their vast energy demands. CHP natural gas turbines, for instance, provide a stable and reliable power source that is essential for maintaining uninterrupted AI operations. However, global demand for these turbines and generators has surged, outpacing production capacity and leading to significant backorders and lengthy lead times. These delays, often extending beyond 18-36 months, have createda bottleneck in the power supply chain, hindering the deployment of new hyperscale AI facilities. As a result, these power generation constraints pose a critical challenge to scaling AI infrastructure and meeting the growing energy needs ofAI-driven workloads. Addressing these delays is vital for ensuring the continued expansion and functionality of AI data centers.

4. High-Performance AI GPUs

The computational core of hyperscale AI data centers relies on high-performance AI GPUs like NVIDIA’s H100 and GB200 (as seen in Fig.1), which are crucial for processing the massive workloads involved in training and deploying multi-trillion parameter AI models. However, rising demand for these GPUs, coupled with global semiconductor shortages, has caused significant supply chain bottlenecks. The limited availability of these vital components is slowing down AImodel training and restricting data centers’ ability to scale to meet the growing computational demands of LLMs. For instance, the GB200 could face year-long delays due to high market demand, further underscoring the need to address these shortages to ensure the continued growth and operational efficiency of AI infrastructure.

Economic Impact of Delayed AI Infrastructure Deployment

Delays in AI infrastructure deployment may create a critical gap between AI’s vast potential and its practical economic benefits. Supply chain bottlenecks present a serious challenge to the anticipated AI-driven economic boom, which promises to create trillions of dollars in value through rapid deployment of hyperscale data centers.

The inability to scale AI infrastructure quickly is expected to severely impact early-stage innovations, where speed to market determines competitive advantages and leadership in the global AI economy.

These deployment delays may also hinder the training and scaling of Exascale Large Language Models (ELMs)[7], especially those exceeding 1 trillion parameters, where computational demands further exacerbate infrastructure bottlenecks.

The ripple effects extend far beyond project timelines, threatening AI’s ability to revolutionize sectors like healthcare, energy, finance, and manufacturing.

If delays in acquiring land, power infrastructure, and high-performance computing units persist, each quarter represents deferred economic benefits and missed opportunities. This growing gap between AI’s advancements and available infrastructure may slow the transformation from theoretical capability to practical value creation, limiting efficiency gains and innovation breakthroughs.

The mismatch between computational demands and infrastructure readiness particularly affects the training and deployment of next-generation ELMs [7], hindering businesses’ ability to capitalize on AI’s full potential across real-world applications.

Supply Chain and Power Challenges Threaten Advanced Exascale LLM Development Beyond 1–10 Trillion Parameters

The development of Exascale Large Language Models (ELMs) [7], beyond 1– 10 trillion parameters, faces two critical challenges: power grid limitations and bottlenecks in the supply chain for GPUs and electrical power equipment. Training these advanced models requires both vast interconnected high-capacity GPU clusters, powered by cutting-edge processors such as NVIDIA’s GB200 and unprecedented levels of stable power, ranging from megawatts (MW) to potentially gigawatts (GW) — exceeding many regional power grids’ capacity.

The challenge lies not just in securing advanced hardware, but in establishing sustainable power infrastructure capable of supporting these intensive computational workloads.

These dual limitations significantly impact the ability to train and deploy next-generation language models at exascale levels. Current power grid infrastructure and data center designs are approaching their limits, while hardware supply chains struggle to meet growing demands. Without resolving both the power delivery and hardware accessibility challenges, the gap between theoretical AI capabilities and practical implementation continues to widen. The combined effect of these constraints could delay critical AI breakthroughs and impact industries relying on large-scale AI technologies, making power infrastructure as crucial as computing hardware in determining the future of AI advancement.

The Economic Ripple Effect of AI Infrastructure Delays on Global Competitiveness

Infrastructure deployment delays in GenAI-at-scale may create a domino effect that extends far beyond technical constraints. As illustrated in Figure 5, these delays may impact multiple layers of economic value creation — from immediate process automation and cost reduction opportunities to broader implications for national competitiveness and GDP growth.

The lag in AI infrastructure deployment directly affects the timeline for realizing AI’s transformative potential across business innovation, job creation, and broader economic advancement.



Image: Claudio Lima, PhD. Fig. 5 — Impacts of delayed construction and operation of next-generation AI hyperscale data centers



Without timely infrastructure development, several critical aspects of the AI economy may be significantly affected

1. AI-GDP Growth for AI-Driven Economies: AI is projected to contribute up to $13 trillion to the global economy by 2030 [1], but this growth is contingent upon the deployment of necessary AI infrastructure. If, for instance, computational and grid delays reduce the annual GDP growth driven by AI by 0.5% or more, this could result in billions of dollars of lost economic output each year. Consequently, this economic shortfall could slow the growth of AI-powered industries,ranging from healthcare to autonomous systems.

2. New AI Job Creation: AI-driven economies depend on the ability to generate high-skilled jobs in areas such as AI research, data science, and automation. However, delays in deploying the necessary infrastructure to support advanced AI systems may also delay these job creation opportunities, potentially stalling the growth of the digital workforce and limiting economic mobility in AI-centric industries.

3. Competitiveness of Companies and Nations: The global race for AI leadership hinges on the ability to rapidly scale infrastructure. Delays in building the required AI infrastructure may hinder the competitiveness of companies and nationsthat struggle to keep pace with energy and computational demands. As a result, some regions could fall behind in AI development, diminishing their influence in technology markets and limiting their ability to attract top talent andinvestment.

4. AI Innovation (New Products and Services Enabled by AI): AI is crucial for unlocking new services and products that drive both economic and industrial transformation. However, without the necessary infrastructure to scale AI model training and deployment, the development of these innovative solutions will be delayed. Industries relying on AI, such as healthcare diagnostics, smart cities, and advanced manufacturing, will face substantial slowdowns in bringing AI-driven innovations to the market.

5. AI Process Automation: Delays in computational and power infrastructure will significantly slow the adoption of AI-driven process automation across industries. AI’s potential to boost productivity and operational efficiency through automation will be undermined, especially in sectors like manufacturing, logistics, and energy management, where large-scale AI solutions have the capacity to revolutionize workflows. As a result, companies will encounter sloweradoption rates of AI technologies, limiting their ability to optimize operations and achieve the anticipated efficiency gains.

6. Cost Reductions: Delays in the deployment of AI infrastructure will directly impact the ability of businesses to achieve significant cost reductions. The efficiency gains from automation, predictive analytics, and optimization, all driven byAI systems, will be postponed. Consequently, businesses will experience higher operational expenses, delayed returns on their investments, and a slower realization of AI’s economic benefits, undermining its role in reducing costs across various sectors.

The Economic Fallout from AI Infrastructure Delays

The expansion of AI infrastructure is critical for unlocking the full economic potential of AI=driven sectors. However, persistent delays in scaling this infrastructure, whether due to power grid limitations or shortages in high-performance computational resources, may lead to severe economic consequences, especially for AI-focused economies. The broader ripple effects include the slowdown of advancements across industries dependent on AI and a potential reduction inGDP growth.

Assumptions and Impact Scenario:

  • Baseline Growth Projections: AI innovations are projected to contribute up to 1–2% in annual global GDP growth by 2030, with AI contributing nearly $13 trillion to the global economy. The total global GDP is expected to reach approximately $130 trillion, with AI playing a central role in future growth [1–6].

  • Potential Reduction in Growth: Delays in AI infrastructure could lead to a 0.5% reduction in GDP growth annually. Although this might seem small, it translates to approximately $650 billion in lost productivity and investment each year (0.5% of $130 trillion global GDP). Over a decade, this would result in more than $6 trillion in unrealized economic value, significantly impacting sectors reliant on AI innovations.

Sector-Specific Impacts:

  • Healthcare: Delays in AI advancements such as diagnostics and drug discovery would slow improvements in global health outcomes. Inefficiencies could limit the ability to tackle health challenges and improve patient care.

  • Manufacturing and Autonomous Systems: AI’s potential to enhance manufacturing efficiency and streamline autonomous systems could be hampered. Delayed infrastructure will prevent industries from leveraging automation and AI-driven operational efficiencies, stifling potential cost reductions and productivity gains.

  • Finance: AI tools used for financial analytics, fraud and risk management would face significant delays, preventing institutions from quickly adapting to market changes, which could contribute to global economic instability.

Job Creation and Competitiveness: AI economies are heavily dependent on rapid job creation in high-skilled fields like AI research, data science, and automation. Any delay in AI infrastructure deployment would slow this job growth, diminishing the competitive edge of nations leading AI development.

Additionally, it may widen the talent gap between AI- powered economies and those that struggle with infrastructure delays, exacerbating global economic inequality.

Broader Implications: The effects of delayed AI infrastructure would also extend to critical areas such as climate change, drug discovery, and robotics:

  • Climate Action: AI’s role in climate modeling and environmental management would be undermined, slowing efforts to mitigate global environmental challenges.

  • Global Competitiveness: Companies may seek regions with more reliable power and computational resources, draining talent and capital from underprepared nations. This could further widen the global economic divide, with lagging nations falling behind as others advance in the AI- driven global economy.

Moreover, nations with delayed AI infrastructure will struggle to attract foreign investment, which may slow technological adoption and economic growth even further.

The relocation of AI companies to regions with better energy infrastructure would exacerbate this issue, pushing underpowered nations further behind in the global race for AI leadership.

Persistent delays could significantly impact GDP growth, diminish job creation opportunities, and ultimately leave nations that lag in AI infrastructure on the periphery of the global economy, watching as others lead the next wave of digital transformation.

Quantifying the Economic Impact of AI Hyperscale Deployment Delays

The economic scenario analysis presented in Table 1 evaluates the cascading impacts of deployment delays in AI hyperscale facilities, specifically examining 500MW and 1GW installations. To contextualize these scales, a cluster of100,000 NVIDIA H100 GPUs — essential for accelerating LLM training from months to days — requires approximately 85–90MW of total facility power. This calculation considers 70MW of raw GPU power (100,000 GPUs at 700W TDP), cooling overhead (PUE 1.1 adding 7MW), and supporting infrastructure (~10–15% adding 8–13MW). Thus, a 500MW facility could support multiple AI training clusters, while a 1GW installation represents the scale needed for comprehensive AI infrastructure supporting multiple concurrent training operations.

The model assesses short, medium, and extended delay scenarios against a projected global GDP of $130 trillion by 2030, where AI is expected to contribute $13 trillion through a 1–2% annual growth enhancement [1–6]. Through impactassessment, this analysis reveals how infrastructure deployment delays can transform from operational setbacks into strategic disadvantages that fundamentally reshape both organizations and nations in the global AI economy.



Image: Claudio Lima, PhD. Table 1 — Impact assessment on critical hyperscale AI infrastructure delay



Note: The scenarios in Table 1 are based on assumptions that require further analysis, and actual power consumption of NVIDIA GPUs may vary depending on specific workloads. Nonetheless, these estimates provide insight into the potential impact of AI infrastructure delays on the innovation speed of AI LLM and ELM model training.

Analysis of Delay Scenarios: Infrastructure Scale and AI Innovation Capacity

The analysis reveals critical relationships between power infrastructure scale and AI innovation capability. For 500MW installations, delays affect approximately 575,000 GPUs across 5–6 training clusters, directly impacting organizations’ ability to conduct multiple concurrent model training operations. At the 1GW scale, delays affect about 1.15 million GPUs across 11–12 clusters, which may cascade based on multiple GW-scale AI data center facilities to represent a significant portion of global AI training capacity.

Short-term delays (1–2Q) primarily impact training velocity. For 500MW facilities, this means delayed deployment of 5–6 concurrent training clusters, affecting organizations’ ability to compress training times from months to days. At the 1GW scale, the impact extends to comprehensive AI research and development capabilities, affecting up to 12 concurrent training operations.

Medium-term delays (3–4Q) create systemic disruptions to AI innovation pipelines. The inability to deploy multiple GPU clusters (5–6 for 500MW, 11– 12 for 1GW) severely impacts organizations’ and nations’ ability to maintain competitive positions in AI development. This is particularly critical as model training increasingly requires multiple concurrent operations for rapid iteration and improvement.

Long-term delays (>4Q) represent strategic capability losses. At both 500MW and 1GW scales, extended delays in deploying multiple GPU clusters create compound effects that reshape competitive landscapes. The inability to support multiple concurrent training operations (requiring 85–90MW per cluster) effectively excludes organizations and regions from participating in advanced AI development.

These findings demonstrate how power AI infrastructure scale directly determines AI innovation capacity. The ability to support multiple concurrent training clusters, each requiring ~90MW, increasingly defines the boundary between leaders and laggards in the AI economy.

In an environment where model training capabilities must scale massively and operate concurrently, the availability of power infrastructure at sufficient scale becomes a fundamental determinant of competitive position in the global AI landscape.

Key Takeaways

The development of Exascale Large Language Models (ELMs), especially those surpassing 1–10 trillion parameters, is increasingly constrained by power grid limitations and supply chain challenges. These AI systems demand immense, stable power infrastructure and face significant delays in deployment, which could widen the gap between AI innovation and real- world implementation. Here are the core takeaways from these scenario implications:

1. Surging Power Demand: The rapid growth of hyperscale AI data centers, fueled by multi-trillion parameter models, has led to unprecedented energy needs, ranging from 100 MW to multiples of hundread MWs to scale up to 1 GW and more, per AI data center, far exceeding traditional data center requirements, creating immense pressure on existing power grids.

2. Grid Infrastructure Delays: Power grid upgrades, such as building new substations and transmission lines, often take 6–10 years to complete. These long lead times are creating significant bottlenecks, delaying AI infrastructure deployment and slowing progress in the expansion of hyperscale AI data centers.

3. Supply Chain Shortages: There are critical shortages in key components like MW-scale power solutions, including medium-high voltage transformers, UPS systems, and electrical systems. Lead times for these essential parts can exceed 24–36 months, further slowing the construction of AI infrastructure.

4. Economic Impact: Power shortages and delays in infrastructure development could reduce annual GDP growth by up to 0.5%, particularly for AI-driven economies. This reduction could slow innovation cycles, limit automation, and decrease global competitiveness, leading to broader economic repercussions.

5. Delayed AI Infrastructure Scaling: Insufficient power and GPU availability can significantly hinder AI innovation, slowing down large- scale model training and reducing competitiveness. AI hyperscale data centers, requiring 100 MW to 1 GW, face long-term delays without adequate power grids and infrastructure. If these delays extend, they will impede the development of multi-trillion parameter AI models and reduce concurrent training capacity, placing nations and organizations at a strategic disadvantage in the global AI economy.

6. Broader Implications: If the current energy and supply chain challenges persist, AI advancements across vital industries like healthcare, finance, and autonomous systems will face significant delays. These bottlenecks threaten the broader societal and economic benefits AI promises, stalling transformative innovations that could address pressing issues in these sectors.

Addressing these critical challenges is essential to unlocking AI’s full potential and ensuring that nations can remain competitive in an increasingly AI-driven global economy.


References

[1] McKinsey & Company, “How Data Centers and the Energy Sector Can Sate AI’s Hunger for Power”, 2023.

[2] The Oregon Group, “$2 trillion Needed in New Energy Generation to Meet Surging Data Center Power Consumption”, October 2024.

[3] IDC, “Artificial Intelligence Will Contribute $19.9 Trillion to the Global Economy through 2030 and Drive 3.5% of Global GDP in 2030, September 2024.

[3] Bain & Company, “Utilities Must Reinvent Themselves to Harness the AI- Driven Data Center Boom”, October 2024.

[4] Wells Fargo, “Wells Fargo Predicts AI Power Demand to Skyrocket by 8050% by 2030”, 2023.

[5] Beth Kindig, “AI Power Consumption: Rapidly Becoming Mission- Critical”, Forbes, 2024.

[6] Goldman Sachs, “AI Poised to Drive a 160% Increase in Power Demand”, 2023.

[7] C.Lima, “Building the Future of Generative AI Digital Infrastructure: Introducing Exascale Language Models (ELM) and the Path to AGI”, Medium, October 2024.


About the author

Claudio Lima, Ph.D., is a pioneer in the digital transformation of numerous industries, leveraging technologies such as Generative AI/LLMs, Quantum Computing, IoT, and Blockchain/DLT. He specializes in nurturing emerging companies and is the co-founder of cutting-edge startups in Generative Artificial Intelligence and Quantum Technologies, helping to drive innovation across various sectors. He is the author of 15+ USPTO patents, chair of IEEE Standards, and widely regarded as a global thought leader. His expertise spans energy/renewables, smart cities, telecommunications, and cybersecurity. Passionate about exploring new frontiers, he consistently pushes the boundaries of what is possible with GenAI and quantum technologies. Currently, Dr. Lima is focused on designing cutting-edge GenAI Exascale Language Models (ELMs), AI Agentic Autonomous solutions, Modular Quantum Computers, GigaWatt Hyperscale, and high-performance LLM Inference Data Centers, shaping the future of AI and quantum digital infrastructure at a transformative scale.
